Standard and dynamic schedules
A schedule tells KAMI when someone is expected to work, so it is what their attendance is judged against. A standard schedule is a week that repeats for one employee with no end date. A dynamic schedule is not a setting: it means scheduling week by week, on the calendar, with Bulk Event, or by importing a rota. Use this article to give someone a repeating week, schedule a group, or load a rota from a spreadsheet.
Where:
- One employee's repeating week: their profile › Attendance › Standard Schedule
- A group, for set weeks: Attendance › Calendar › Bulk Event
- A rota from a spreadsheet: Settings › Bulk Data › Import / Export › Bulk Schedule, or Import in the Bulk Schedule window
You need:
- The Standard Schedule right, in My Team user rights, to edit someone's standard schedule
- Attendance Manager to use Bulk Event. With Attendance Administrator too, events are created at once rather than as requests
- Bulk Data, in Attendance user rights, to import a schedule
Which one, when
| Your team | Use | Why |
|---|---|---|
| Works the same week, every week | A standard schedule from an event template | Set once. It repeats until you change it |
| Repeats a pattern for a known number of weeks | Bulk Event with Recurring Schedule | Fast for a group, and it stops when you say |
| Works a rota that changes every week | The team calendar, Bulk Event, or the Bulk Schedule import | You state each date, so nothing is assumed |
| Needs headcount covered at each branch | Auto-schedule | It builds the week against your staffing requirements |
| Has optional extra shifts | Open shifts | Extras on top of the rota, never the rota |
| Needs one day added or changed | The team calendar | No template needed |
Scheduling a repeating week by hand works, and means someone rebuilds it every week. If the pattern repeats, use a standard schedule.

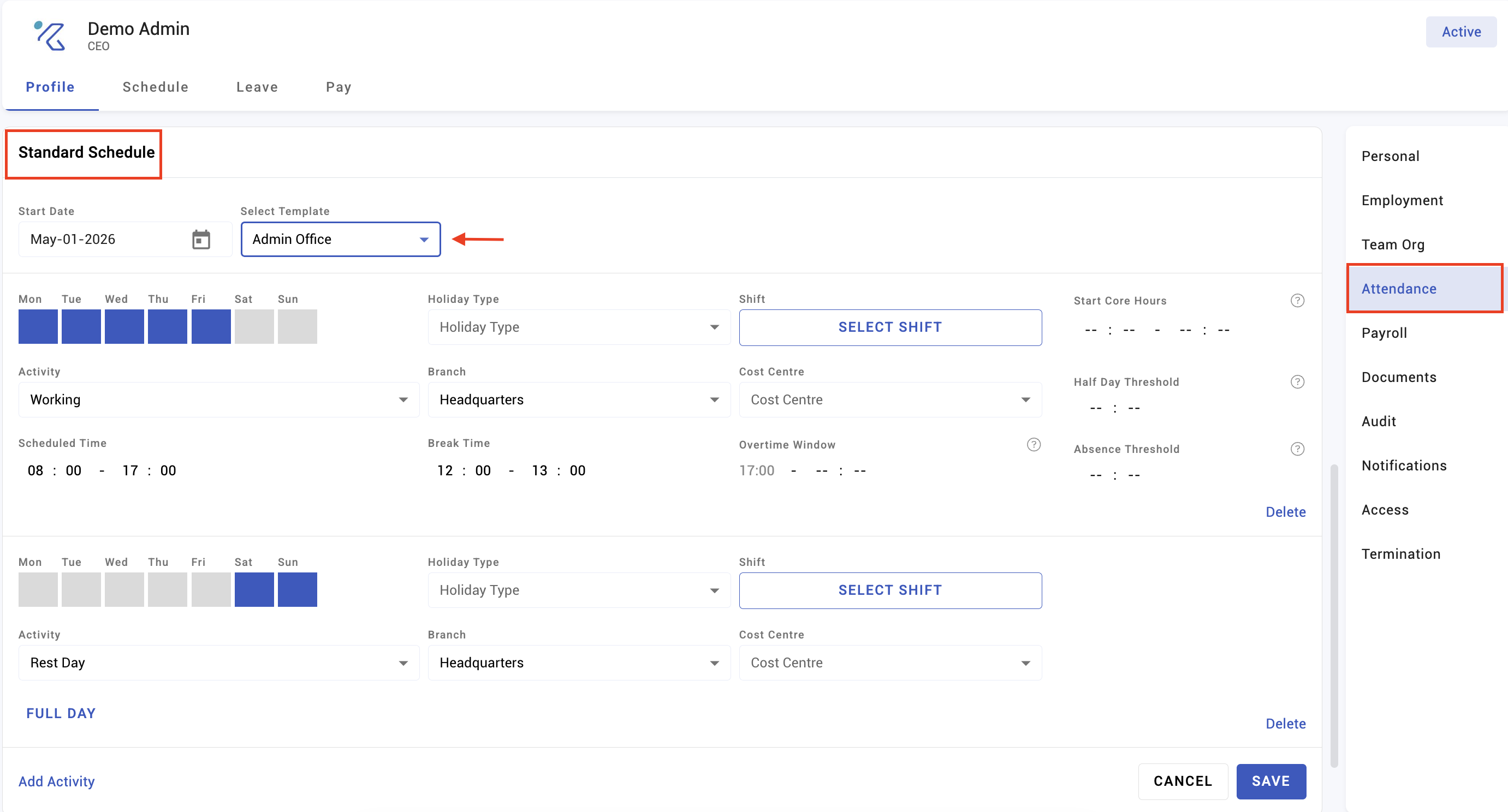

How to set one employee's standard schedule
- Open their profile › Attendance and find Standard Schedule. Select Edit.
- Set the Start Date. If they already have a schedule, it must be tomorrow or later. It cannot be before their hire date.
- Under Select template, choose an event template. Its events fill in.
- Change any event if you need to: its days, Activity, Holiday Type, Branch, Cost Centre, Scheduled Time, Break Time, Overtime window, Start core hours, Half day threshold and Absence threshold. Select Shift fills an event from a shift. Add Activity adds another event. A non-working activity can be Full day.
- Select Save.

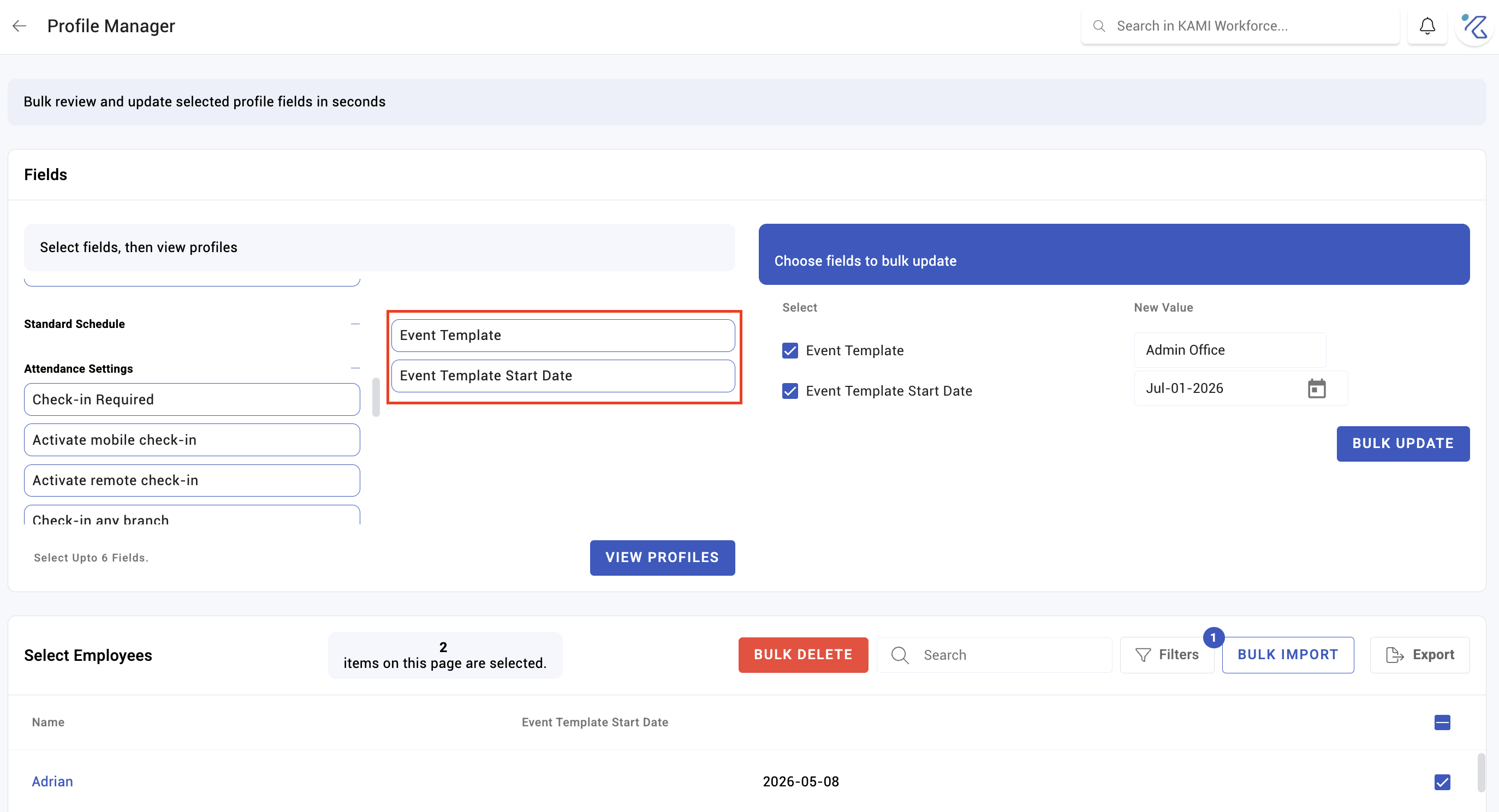

The week repeats from the start date with no end. To schedule a new employee, choose the template at the Standard Schedule step when adding them. To schedule many people, see Event templates.
What saving a standard schedule does
- Days before the start date do not change. The old schedule ends the day before; the new one starts on the date.
- KAMI keeps a year of days ahead and extends it automatically.
- Days you placed by hand win. Where an event added on the calendar overlaps a standard day, the standard day is hidden.
- Approved leave is kept. Standard days that overlap it are removed or trimmed around it.
- Days you deleted come back. Standard days removed from the calendar after the start date reappear when you save.
- Events in the schedule must not overlap on the same day, or it will not save.
- The change is recorded in the employee's audit history.

How to schedule a group with Bulk Event
- Go to Attendance › Calendar and select Bulk Event. The Bulk Schedule window opens.
- Set the Weekly period. It always runs Monday to Sunday.
- Choose people. Under Group Selection, pick a Department, Branch, Cost Centre or Group; an employee must match every one you pick. Under Employee Selection, add named people on top.
- Under Standard Shifts, pick an event template to fill the rows, or build rows yourself. Each row has its days, Select Shift, Activity, Branch, Holiday Type, Cost Center (or Use Profile Cost Center), the scheduled times, the options and Is full day. Add shift adds a row.
- To repeat, tick Activate under Recurring Schedule. Set Start repeating on (a Monday), Every 1, 2, 3 or 4 weeks, and for how many times, up to 52.
- Select Save. If events overlap, choose Insert to fit around them or Overwrite to replace them. Replace entire week clears the rest of each person's week too, after a second warning.
| Option | What it does |
|---|---|

| Follow holiday conversion rules | On by default. Converts days that land on a public holiday, as in Holiday rules |
| Remove existing events | Deletes and replaces the working events on the dates you schedule. Leave is kept |
| Requires manager approval, Requires employee consent | Administrators only. Ticked, events become requests |
| Import | Opens the Bulk Schedule import in a new tab |
Created directly, the events appear at once. As requests, each person gets one combined notification. Over 20 events are created in the background, with a notification when done.
⚠️ Ticking only Requires employee consent currently creates the events without asking for consent. Tick Requires manager approval as well if consent matters.

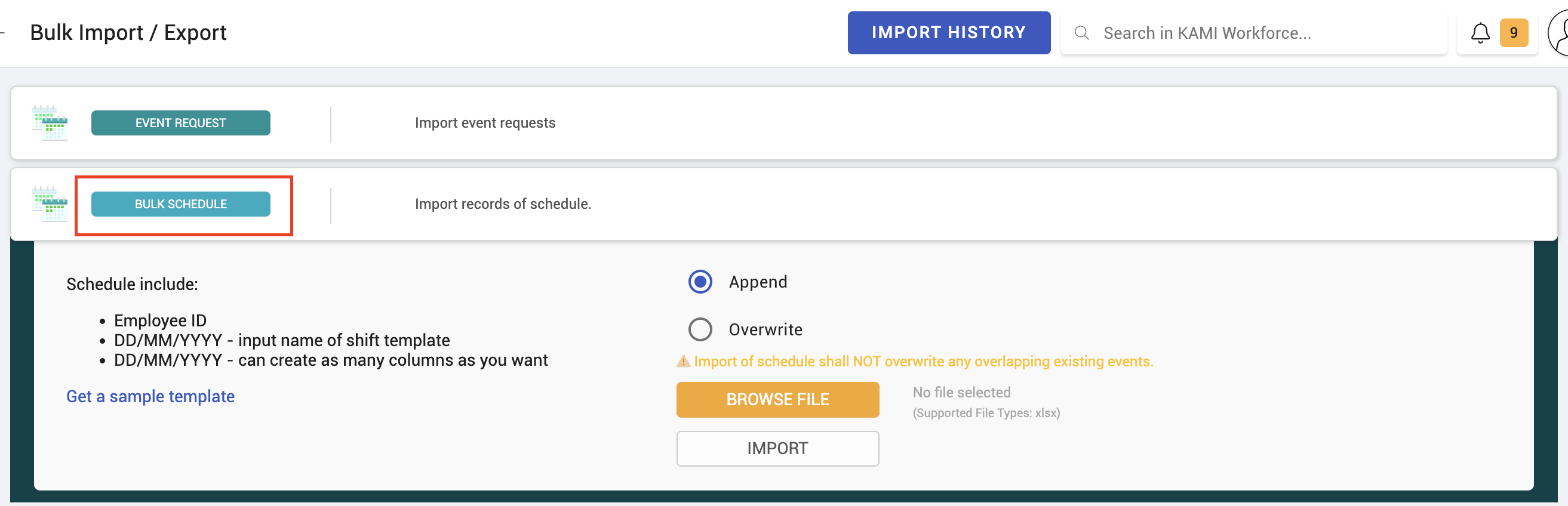

How to import a rota from a spreadsheet
- Go to Settings › Bulk Data › Import / Export and choose Bulk Schedule, or select Import in the Bulk Schedule window.

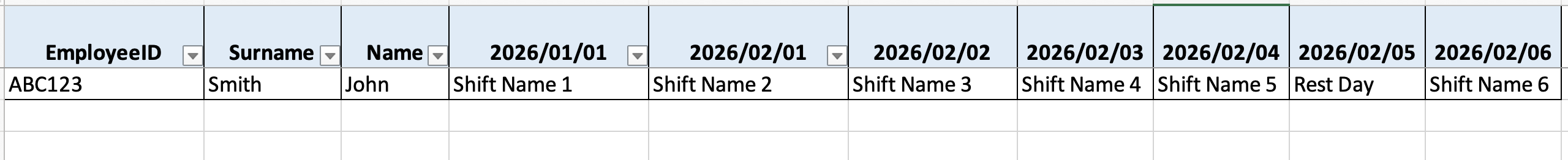

- Download the template. Each row is one employee: EmployeeID, then a column per date, headed YYYY/MM/DD.
- In each date cell, enter the exact Name of a shift. Leave a cell empty for no event.
- Choose Append or Overwrite, then upload.
| Option | What happens to overlapping events |
|---|---|
| Overwrite | Existing events that overlap are deleted, and overlapping leave is cancelled |
| Append | The imported day is skipped where it would overlap |
⚠️ Every shift named in the file needs an activity. A name that matches no shift fails that employee's row. Shift names are not case-sensitive.
Imported days pick up public holiday tags and conversions like any other.
What Happens Next
- Scheduled days become events, and attendance is measured against them.
- No schedule means no expectation. An unscheduled person cannot be late, under time or absent.
- Hours flow to the timesheet, then payroll.
Tips
- Schedule before the period starts. Attendance judged against a schedule written afterwards proves nothing.
- Use one approach per team where you can. A standard schedule plus many hand-placed days is hard to reason about.
- Check an import against the file. Compare a few employees with the rota you meant to load.
- Import with Append unless you mean to replace. Overwrite also cancels leave in the way.
- Rest days are part of the schedule. Blank days cause "why is this person absent on Sunday".
Troubleshooting / FAQ
Q: It says the start date is too early. An existing schedule can only change from tomorrow. Past days are fixed.
Q: I changed the template but employees' schedules are unchanged. Expected. Apply it again.
Q: Days I deleted have come back. Saving a standard schedule restores standard days deleted after its start date. Delete them again, or change the schedule.
Q: Only some rows imported. Rows with an unknown employee ID or shift name fail. Check the import result.
